Design, installation and acceptance close into a loop, and each gate leaves a record somebody signs. No grey areas left for later.
Goods-in inspection, power-up of every unit and verification of the written parameters — each device is confirmed working before it goes to site.
Fibre links, feeder VSWR, single-antenna signal and area strength measured and tuned section by section until they match the design values.
Call quality, safety functions, management functions and a 24-hour concurrency load test — the whole system passes as one.

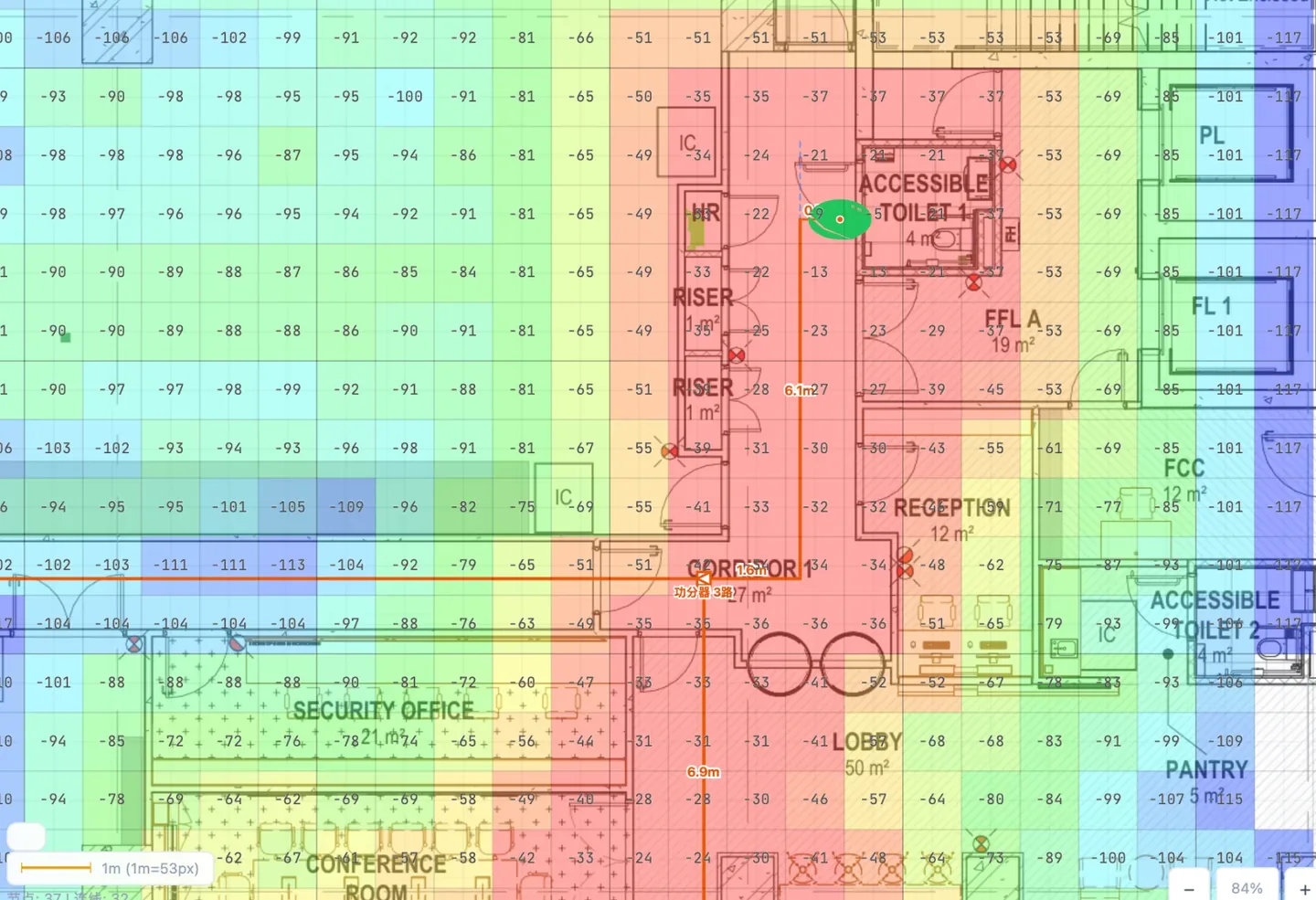

Acceptance is not a matter of opinion. Signal strength is measured point by point across the target area with instruments, and the proportion of points meeting target is the coverage figure — re-measured by the same method used at design stage, and it only passes if the two agree. A listening assessment of call quality is added on top, so the result is both quantitative and qualitative.
Base stations, remote units and antennas report their state into one platform; faults, fibre breaks and anomalies raise alarms in one place; terminal position and call activity are managed together. For a maintenance team it plays the role DCIM plays in a data centre — only for the wireless layer.
The record does not break: when a later phase comes, the original design baseline is still there to check against.
Design baseline and configuration record established.
Equipment enrolled in management, topology synced.
Live monitoring and alarm response.
Coverage re-measured and parameters adjusted.
Expansion, upgrades and software updates.
Test records, acceptance reports and as-built drawings all follow one template, so they carry across projects and stand up to an owner's audit later. Any number in them can be traced back to the design basis it came from — and when the site expands or is refitted, they are the first thing anyone reads.
Three acceptance gates, a coverage health report and one management platform — maintainable from the day it is handed over.
